Legacy modernization and replatforming

Modernize the system your business cannot switch off

Old systems are usually full of rules nobody wrote down and data nobody can afford to lose. We replace them in stages, so the business keeps running, the rules are kept and the old system is retired only when the new one has proved it matches.

  • Rules recovered and documented
  • Old and new run side by side
  • Every record reconciled at cutover

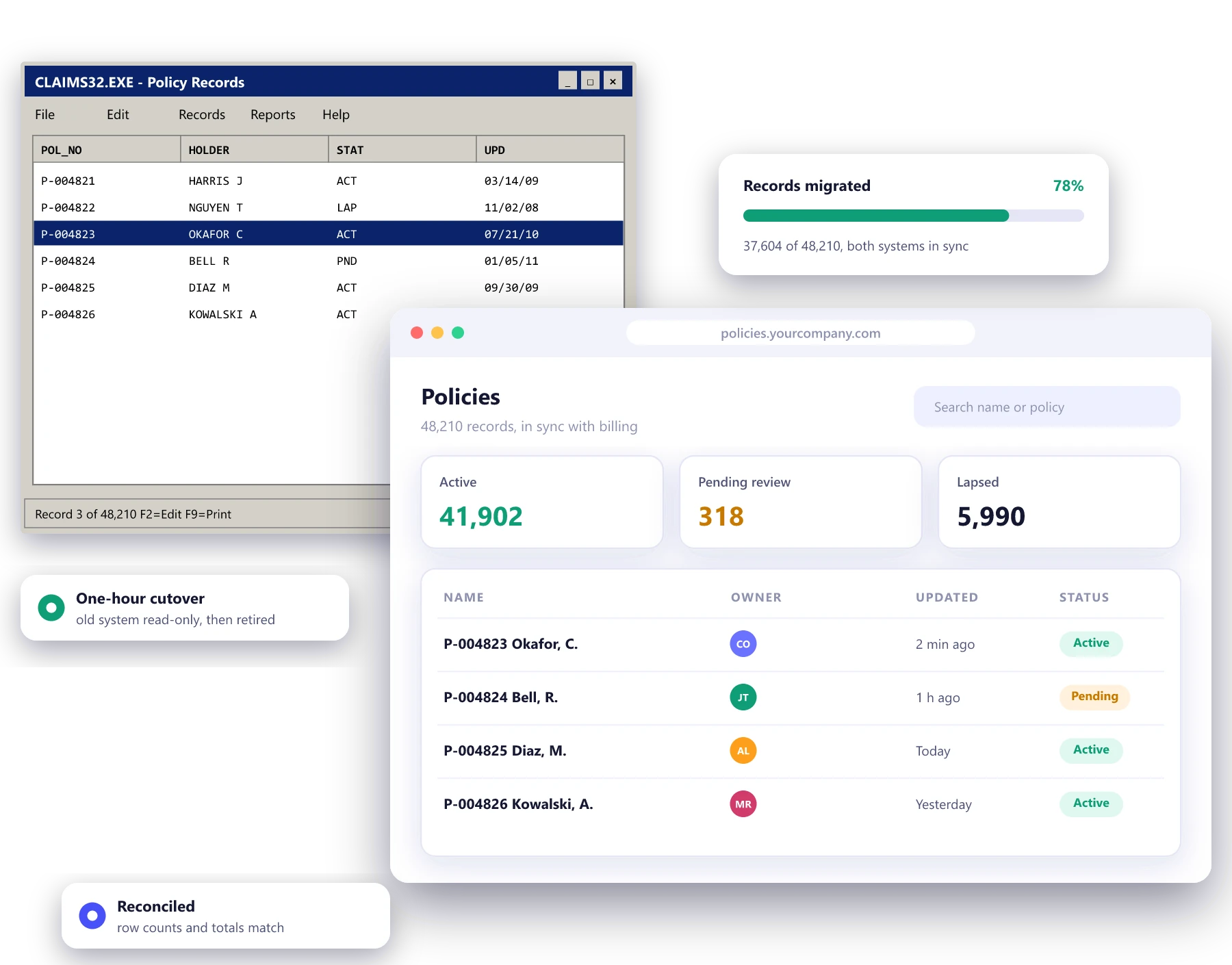

An old desktop policy records screen being replaced by a modern web application, with a migration progress card showing records moved
Why now

Signs a system needs modernizing

Only one person can change it

A single developer or contractor understands the code, and every change waits for them.

It cannot be patched

The operating system, framework or database is out of support, and security updates stopped years ago.

It will not connect

New tools need an API the old system does not have, so data moves by export, import and hope.

Simple changes take months

Every change breaks something else, so the business has learned to stop asking for improvements.

Choosing a route

Five ways to modernize, and when each makes sense

Modernization is rarely one decision. We look at each part of the system and pick a route for it, which often means rehosting some parts, refactoring others and replacing a few with a product you can buy.

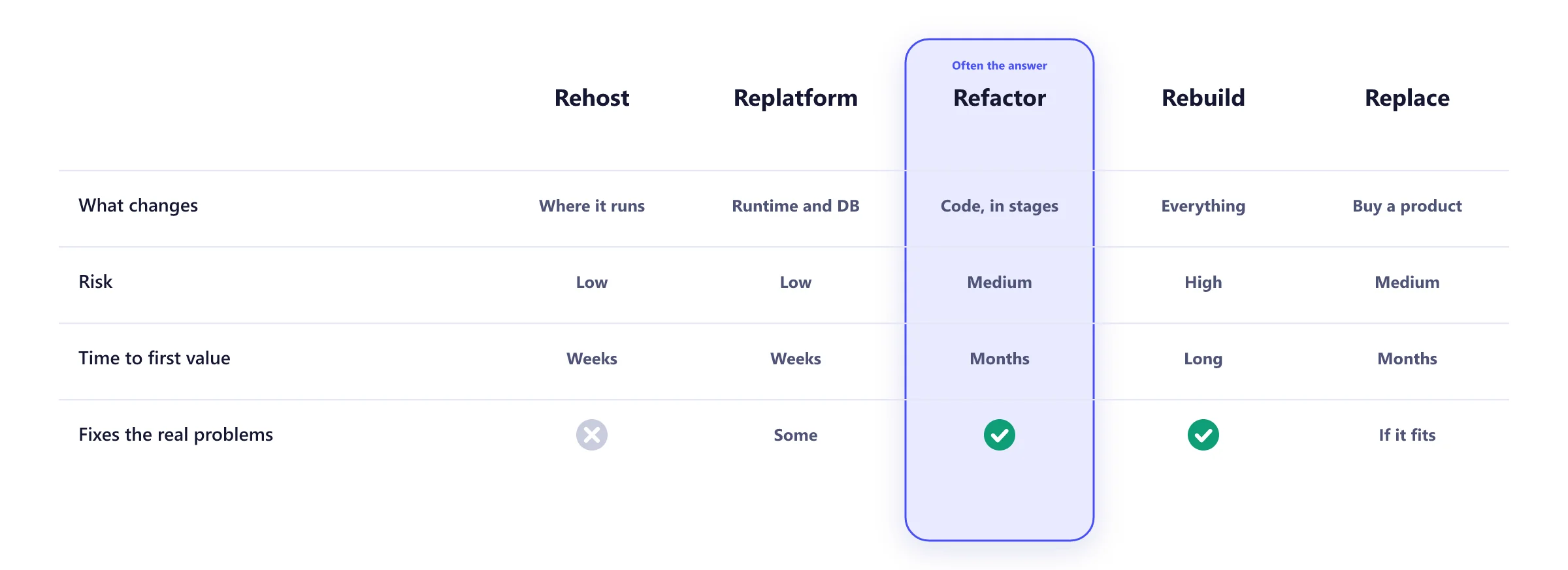

Comparison of modernization routes: rehost, replatform, refactor, rebuild and replace, by risk, cost, time and how much changes
Staged replacement

Replace it one piece at a time

A routing layer sits in front of the old system. Each release moves one part of the business onto new code, runs it in parallel until the results match, then switches it over. This is sometimes called the strangler pattern, after a vine that slowly replaces the tree it grows on.

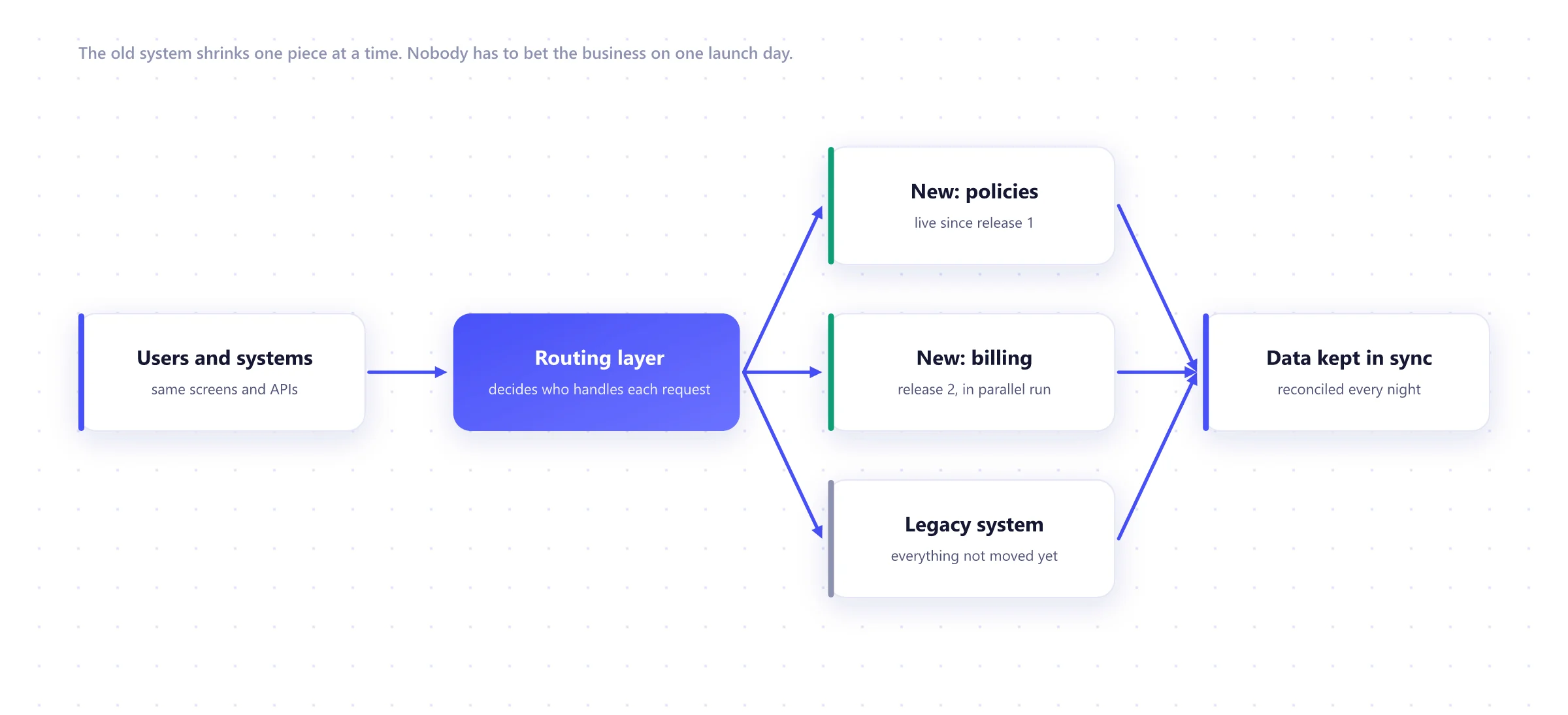

Staged modernization: a routing layer sends each part of the business to either the legacy system or new services, and the legacy system shrinks until it can be retired
  1. Assess

    3 to 6 weeks

    Code, data and usage mapped. Rules written down. A route chosen for each component.

  2. Foundations

    3 to 5 weeks

    Routing layer, new hosting, data sync and monitoring in place before any cutover.

  3. First slice

    2 to 4 months

    The most painful part rebuilt, run in parallel and switched over.

  4. Next slices

    In releases

    One part at a time, each reconciled before the old code is turned off.

  5. Retire

    Final release

    The legacy system is archived, with its data kept for audit.

Technology

What we modernize from and to

Moving from

  • VB6
  • Classic ASP
  • Delphi
  • Old PHP
  • Access
  • Magento 1

Moving to

  • .NET
  • Java
  • Node.js
  • Python
  • React
  • Angular

Data

  • SQL Server
  • Oracle
  • PostgreSQL
  • Change data capture

Cloud

  • AWS
  • Azure
  • Google Cloud
  • Kubernetes

Routing

  • API gateway
  • Reverse proxy
  • Feature flags

Quality

  • Parallel runs
  • Reconciliation reports
  • Contract tests
Questions

Legacy modernization FAQ

Should we rewrite the old system from scratch?

Rarely all at once. A big-bang rewrite has to reproduce years of undocumented rules before it can go live, which is why so many overrun. We usually replace the system piece by piece, routing one part at a time to new code while the old system keeps running. Our guide to legacy system modernization compares the options.

What if nobody understands how the old system works?

That is normal. We read the code, the database and the logs, interview the people who use it, and write down the rules we find. That document is often the most valuable thing a modernization produces.

Can the business keep running during the migration?

Yes, that is the point of doing it in stages. The old and new systems run side by side, data stays in sync, and each piece switches over only after its results match.

How do you make sure no data is lost?

Every migration is rehearsed on a copy of production data first. We reconcile row counts and totals between the old and new systems, and check a sample of records by hand, before and after each cutover.

How long does modernization take?

It depends on the size of the system. A first slice, usually the most painful or most used part, can be live in three to four months. Replacing a whole system typically takes a year or more, delivered in releases.

Do we have to move to the cloud?

No. Moving to the cloud is often part of it, but some systems are better rehosted first and modernized later, and some parts are best replaced with an off-the-shelf product. We recommend a route per component.

Tell us about the system you are worried about

What it does, what it runs on and what keeps going wrong. We will suggest a route and the safest first step, even if that step is just an assessment.

Start a project Prefer to talk? Call +1 (281) 888-0742.
